Budgeted vs. actual expenses
A project's costs other than labor are recorded twice in EVX Software. A budgeted expense is the forecast: what the project expects to spend, and what it will charge the client for it. An actual expense is what was really spent. Comparing the two shows whether the project is staying on budget.
Jump to:
- Budgeted expenses: the plan
- Actual expenses: what was spent
- How they compare
- Where you see the comparison
- Example: laboratory analysis
Budgeted expenses: the plan

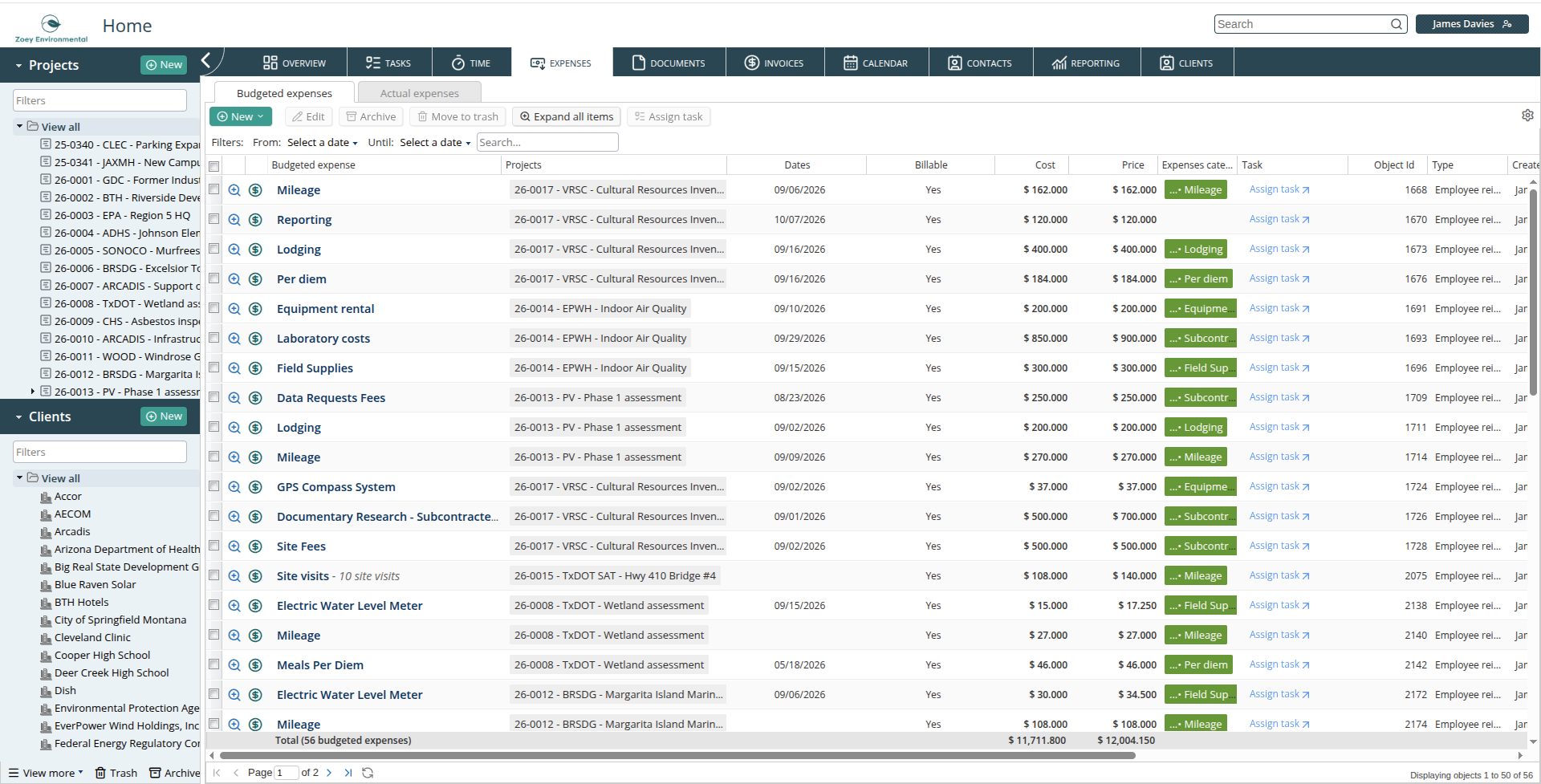

Project managers add budgeted expenses when they plan a project, often from the proposal. Each one lists items with a product type, a quantity, a unit cost, and a unit price, so it carries both what the firm expects to pay and what it expects to bill. The Budgeted expenses list shows the cost and price of each one, and the totals for the list.
The totals at the bottom add up the cost and price of the budgeted expenses shown.
Actual expenses: what was spent
Actual expenses are recorded as costs happen: a mileage claim, a hotel night, a laboratory invoice. Each one records the date, the quantity, the cost and price, the employee or vendor, and an approval status. An actual expense can be linked to the budgeted expense it uses, and the Actual expenses list shows that budgeted expense on each row.
How they compare
| Budgeted expense | Actual expense | |
|---|---|---|
| When | During planning | When the cost happens |
| Who records it | Usually the project manager | Whoever spent it, or accounting for vendor bills |
| Dates | Expected date of each item | Date of each line, and a Due date |
| Approval | Not part of the approval flow | Submitted and approved before invoicing, if your firm approves expenses |
| Used for | The project budget and the price quote | Invoices, the actual cost of the project |
Both carry the same members in Related to: project, client, vendor, rate schedule, expense category, and job phase. That is what lets reports put the plan and the actuals side by side.
Where you see the comparison
- Expenses progress on the dashboard compares actual expenses with budgeted expenses over time. See Overview and dashboard.
- The budget reports show the plan against the actuals by project and task. See Forecasting and Budget control report.
Example: laboratory analysis
A project manager budgets $850 of laboratory costs for an indoor air quality study, priced to the client at $900. The laboratory's invoice arrives at $910. Accounting records it as an actual expense from the budgeted line. Expenses progress shows the project $60 over its laboratory cost plan, and the project manager decides whether to bill the difference.
What you can do next
- Adding budgeted expenses to plan a project's costs.
- Adding actual expenses to record a cost.
- Project budgets and financial control for the whole project budget.
